Project Summary (by Brian J. Behe)

The following project summary was composed by Brian J. Behe, who had the opportunity to work full time on the K-4 Restoration project (along with Jeff Miller and several volunteers).   The project, from April 2001 through December 2001,  is described.  Brian also took most of the photographs.

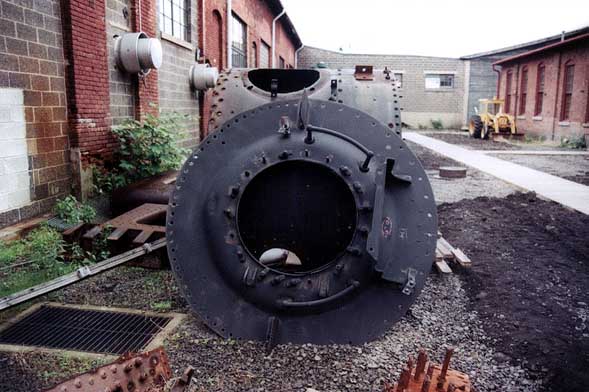

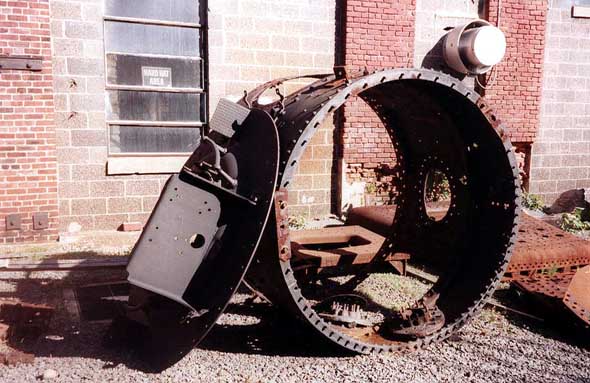

5-01_1.jpg (54391 bytes) Original smokebox with smokebox door. (C. Behe) May 2001 J1.jpg (59647 bytes) Original smokebox with smokebox door, original backhead on ground to the right.

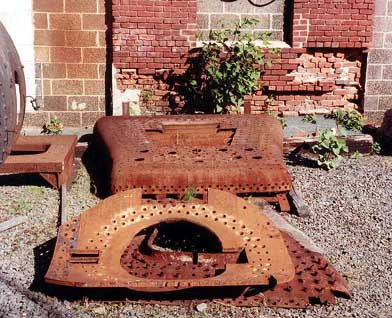

J2.jpg (49133 bytes) Front- Section of boiler cut out due to cracks.  Replaced by patch.

Rear-Original backhead removed due to deterioration


J2.jpg (49133 bytes) Front- Section of boiler cut out due to cracks.  Replaced by patch.

Rear-Original backhead removed due to deterioration

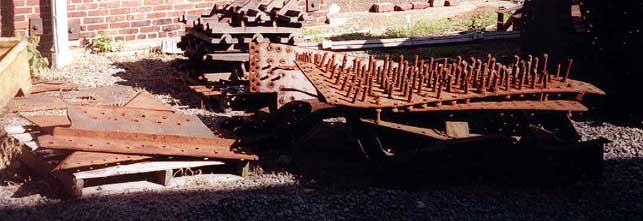

Removed firebox plates with cut stay bolts exposed.





Washout Flanges

Stud bolts were fabricated and installed onto the two washout flanges located on the belly of the boiler.   The stud bolts were fabricated by first cutting bar stock to length.   The cut bar stock was chamfered on both ends, then the thread was cut onto the bar stock on both ends with an unthreaded section in the middle of the bar stock. (April 16 and 17, 2001)   The rear washout flange was riveted into place with the assistance of volunteers Larry Yingling and Stuart Albright. (June 7, 2001)

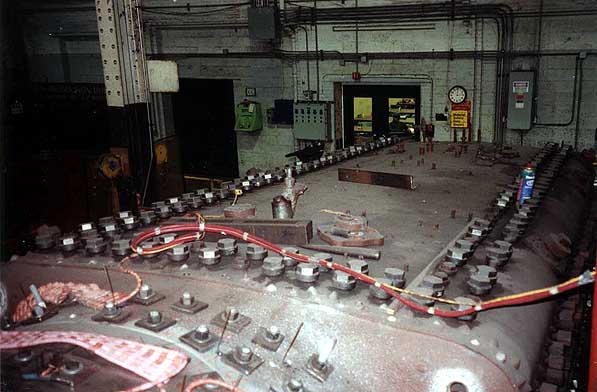

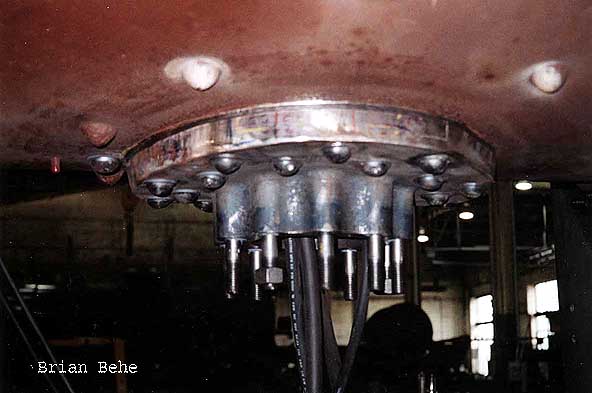

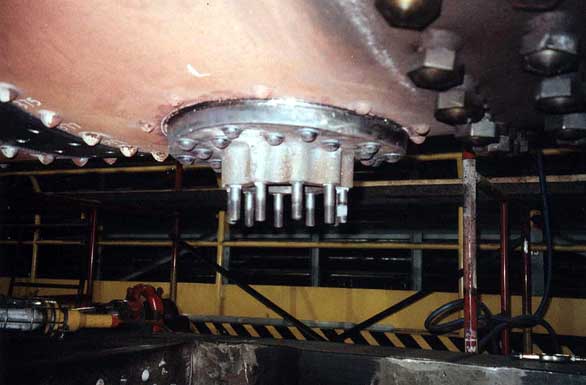

1.jpg (36414 bytes) Front Washout Flange in belly of boiler 2.jpg (34568 bytes) Rear washout flange (handhold) without bottom plate.

 Caps for the washout flanges in the belly of the boiler were machined and drilled to fit onto the stud bolts of the flanges. (April 21 and 22, 2001)

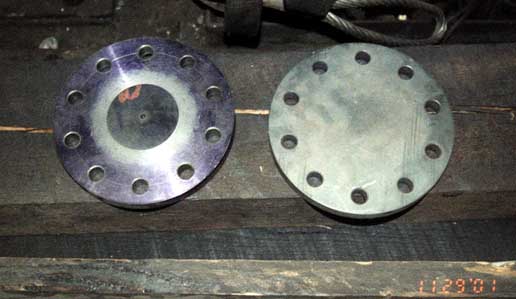

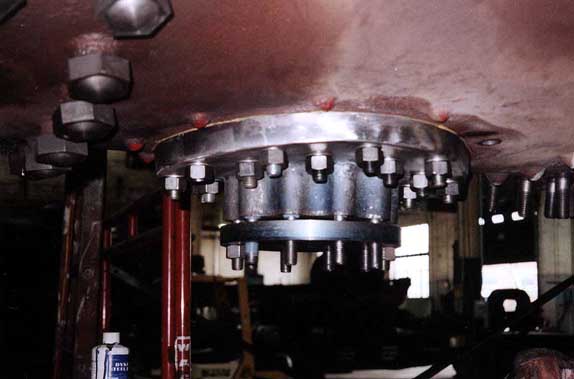

11-01_23.jpg (28071 bytes) Washout Flange caps.  (C. Behe)  November 2001 3.jpg (30478 bytes) Rear washout flange in belly of boiler (with cap loosely fit).



Smokestack Replacement

Bottom edge of smokestack was ground in preparation for a rough fit on the smokebox. (April 15, 2001)   New smokestack was fabricated due to cracks around bolt holes in original smokestack. (To date, smokestack has not been rough fit on smokebox.)

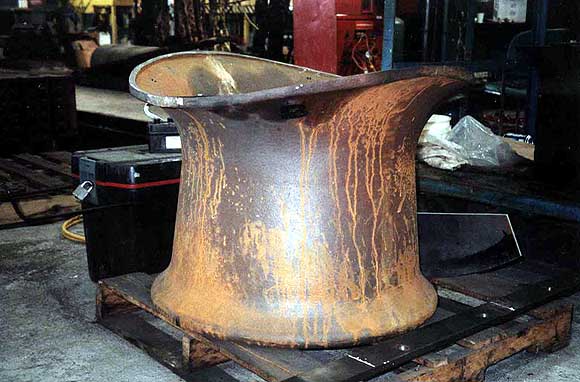

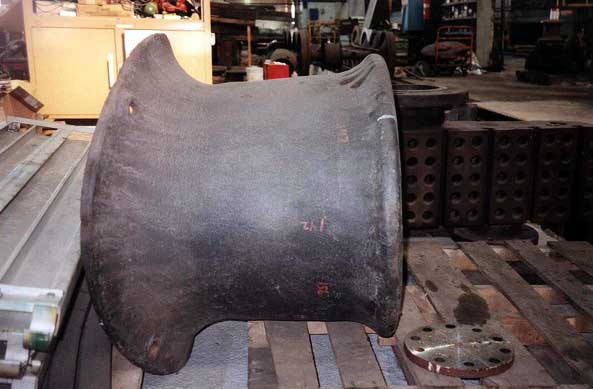

4.jpg (51834 bytes) New smoke stack. 5.jpg (37822 bytes) Original smokestack laying on its side.  Removed due to cracks around bolt holes.



Stay bolt Replacement

Due to being welded over on the inside of the firebox or being damages due to age, a number of rigid stay bolts and some flexible stay bolts, needed to be replaced.   The process of replacing the stay bolts began with the excess weld being ground off the inside of the firebox on both the left and right sides of the engine.   Once the grinding of all excess was complete, removing the stay bolts to be replaced began.

Removing the rigid stay bolts to be replaced started with grinding the “caps” off the stay bolts so that the stay bolt is flush with the side sheet of the firebox.   The next step is to burn out the stay bolt with a cutting torch, taking care not to gouge the side sheet. (Volunteer Wayne Laepple assisted in the burning out of the stay bolts.)   The remaining pieces of stay bolt are then knocked free of the hole using a hammer and chisel.

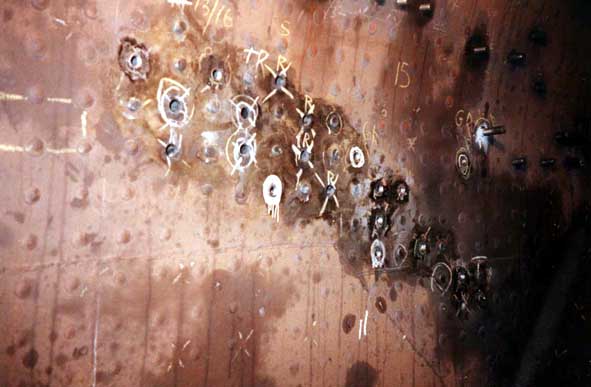

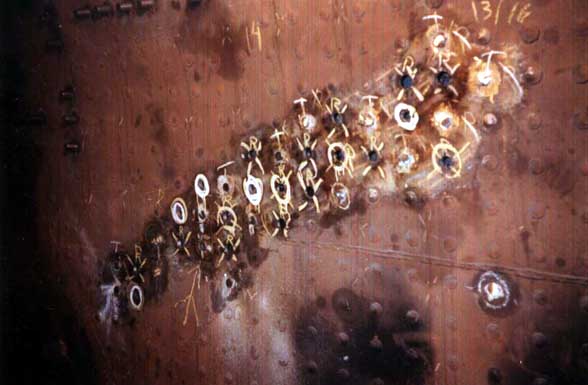

6.jpg (34343 bytes) Rigid stay bolts being replaced on inside (right) of firebox. 7.jpg (36309 bytes) Rigid stay bolts being replaced on inside (left) of firebox.

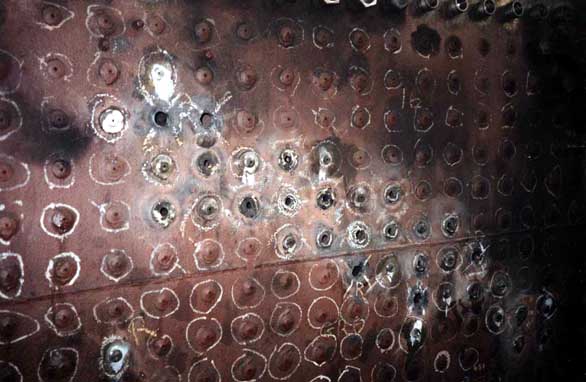

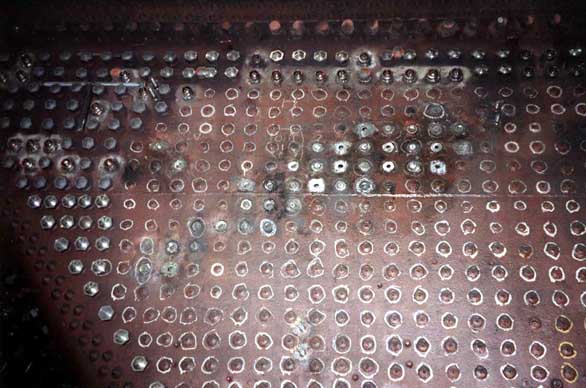

8.jpg (52381 bytes) Closeup of rigid stay bolts being replaced on outside (left) of firebox. 9.jpg (44227 bytes) Closeup of rigid stay bolts being replaced on outside (right) of firebox.

After the stay bolts were removed, the original threads in the stay bolt are reamed out using various reamers and an air motor until the hold is smooth.   The holes are then welded to reduce the size the hole or to repair a crack in the metal, if necessary.   Once welded, the weld is ground down flush with the sheet.   The holes are then reamed out to a slightly smaller diameter than the replacement stay bolts.

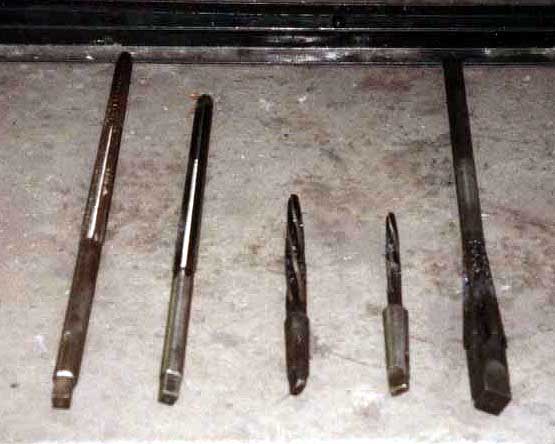

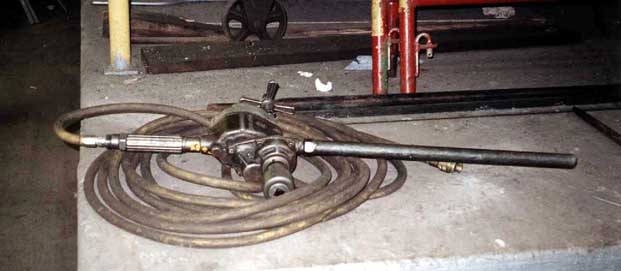

12.jpg (37772 bytes) Reamers used for rigid stay bolt holes. 13.jpg (28977 bytes) Air motor used for reaming holes.

Certain stay bolts needed bushings on the outside sheet.   These bushings, if necessary, were ground off flush with the side sheet, then knocked out and replaced.   The replacement bushings were machines down with a taper and were put into the original hole which was cleaned of rust and dirt then welded into place. (Volunteers Walter Elvidge and Barry Claar assisted in machining the bushings to size.)   Excess weld is ground off.

The stay bolt holes, once reamed out, are tapped out to the diameter of the replacement stay bolt. (Volunteer Wayne Laepple assisted in tapping out the holes.)

After the stay bolt holes are tapped out, the stay bolts are then screwed into place. (Photo 14; Volunteer Jim Ward assisted in making new stay bolts.)   The stay bolts are screwed in until ¼” is extending past the side sheet on the outside of the firebox.   The excess stay bolt on the inside of the firebox is cut off with a torch then ground down to ¼”. (Volunteer Gary Creighton assisted in the grinding off of stay bolts.)

The final step of stay bolt replacement is to use an air hammer and a bucking tool (Photo 15) to hammer the stay bolts down to 1/8” .   If hammering flexible stay bolts, a collar with a piston fits onto the flexible stay bolt sleeve to prevent the weld holding the sleeve from cracking. (Volunteers Gary Creighton, Walter Elridge, Tim Barney, and Adam Counterman assisted in hammering stay bolts.)

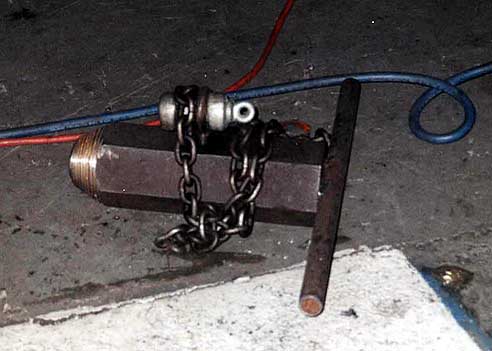

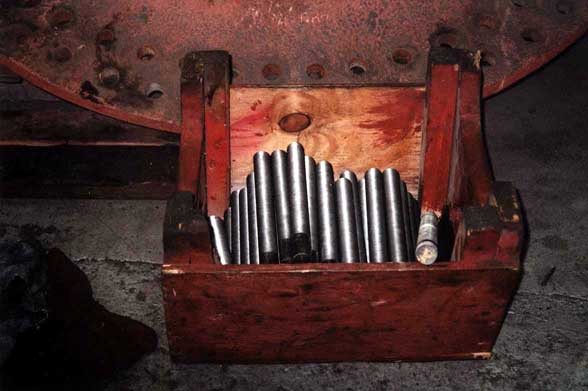

14.jpg (35196 bytes) Photo 14. Box of rigid stay bolts for firebox.   15.jpg (31981 bytes) "Bucking" tool for hammering stay bolts after installation.

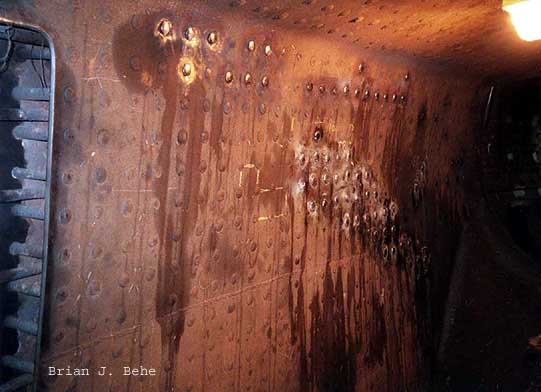

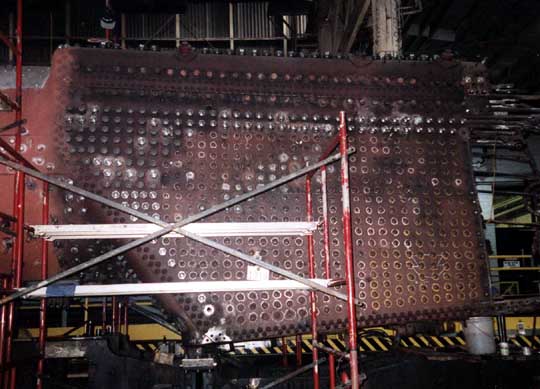

10.jpg (36275 bytes) Left side (inside) of firebox - completed stay bolt replacement. 11.jpg (46324 bytes) Left side (outside) of firebox - completed rigid and flexible stay bolt replacement.

Rigid stay bolt replacement and hammering complete on left side of firebox. (Note:   Stay bolts installed in right side of firebox are yet to be hammered.   Also, approximately 400 stay bolts will need to be installed on the side sheets and backhead after they are welded into place.)   (April 18 – August 1, 2001)



Boiler Patch Project (May 14 – June 8, 2001)

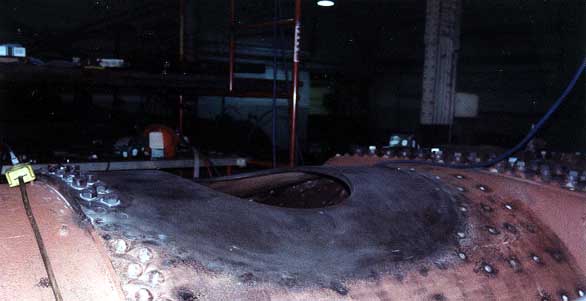

5-01_22.jpg (25472 bytes) Boiler in area of Steamdome, Prior to being patched.  May 2001. (C. Behe)

Due to the discovery of cracks between the rivet holes on the boiler when the steam dome was removed (date unknown), it was determined to replace the cracked section of boiler with a six-by-six patch of one inch thick steel.   Before welding the patch into place, the area on each side of the seam was heated to 200 ° F.   The steel was to remain at 200 ° F for the duration of the welding.   This was accomplished by using ceramic heating pads installed on May 14, 2001.

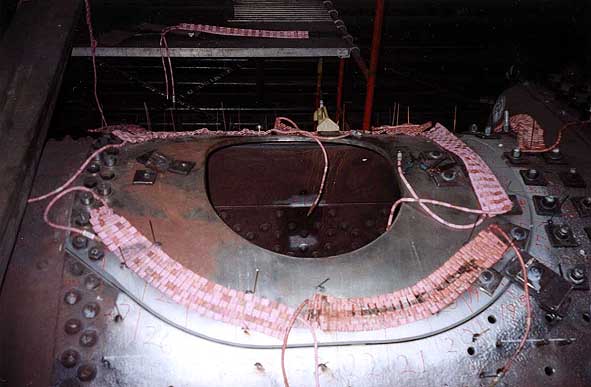

B1.jpg (41501 bytes) Ceramic heating pads to heat patch to 200 degrees F.  Placed along inside and outside of the grove.  5/14/01 B2.jpg (48575 bytes) Top of Firebox.  Ceramic heating pads in the foreground.   5/14/01

Inside the boiler, a platform was erected to provide a surface for the welders to work from.   A “spider”, or x-shaped brace, was installed to control the distortion of the steel caused by the heat of the welding process.

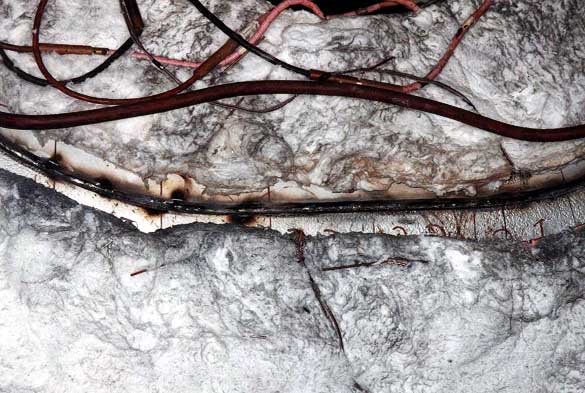

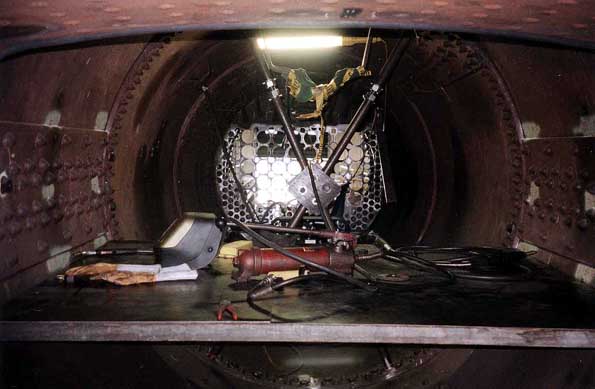

B3.jpg (37174 bytes) Platform set up inside the boiler for the boiler patch welding project.  5/14/01.

After heating the area to be welded, the next step was to tack weld the patch into place.   This tack weld was placed every six inches.

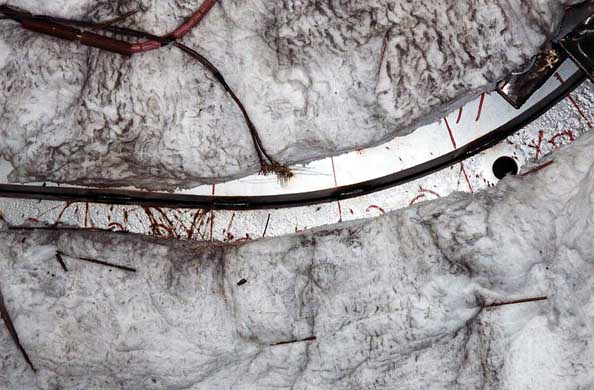

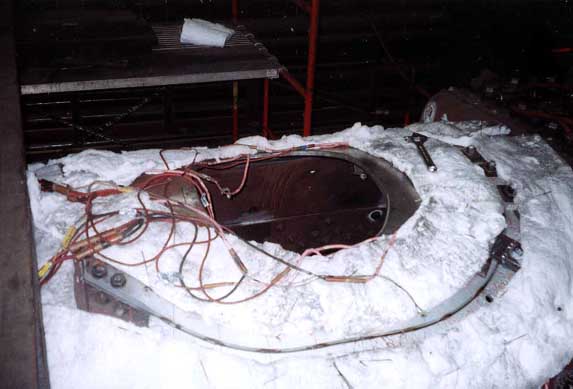

B4.jpg (34553 bytes) Boiler patch - ceramic heating pads covered by insulation (tack welded) 5/14/01 B5.jpg (57184 bytes) Boiler patch - (close up) tack welded (outside boiler)  5/14/01

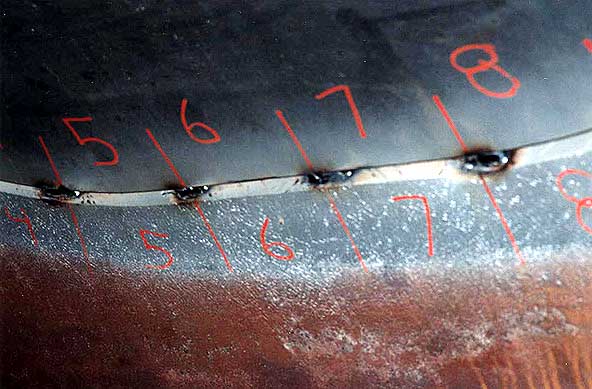

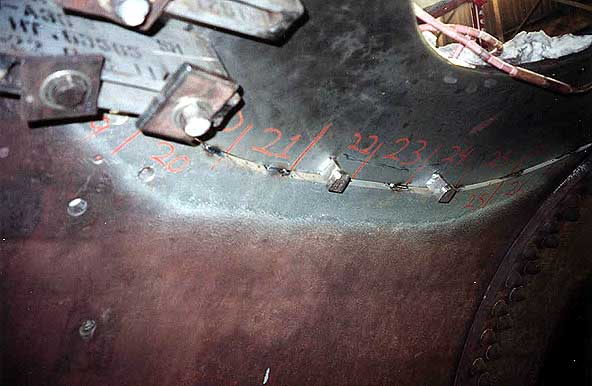

B6.jpg (54174 bytes) Boiler Patch tack welded every six inches (inside boiler).  5/15/01 B7.jpg (42966 bytes) Boiler Patch tack welded every six inches (inside boiler).  5/15/01

Along with Jeff Miller, two welders were contracted for the project.   Bill Frederickson or Hometown, PA and John Scondras of Dalton, PA, provided their welding skills.

B8.jpg (53545 bytes) Welding Contractors Bill Frederickson (L) and John Scondras (R) discussing welding of boiler patch.  5/17/01

The next step was to weld in a root pass.   This involved welding between the tack welds, approximately four to sic inches long, then peening (Hammering) the weld, grinding the edge to be welded into, then wire brushing the weld.   This step was completed by having two welders welding at the same time on opposite sides of the patch.


A second pass was then welded with a welder inside the boiler and a welder outside the boiler welding the same section at the same time.   This second pass, and remaining passes of weld followed the same “weld, peen, grind, brush” procedure described above.

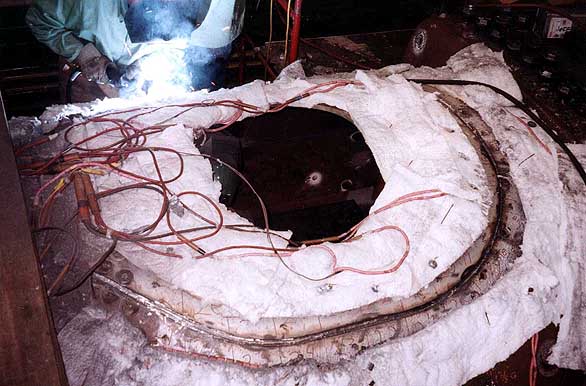

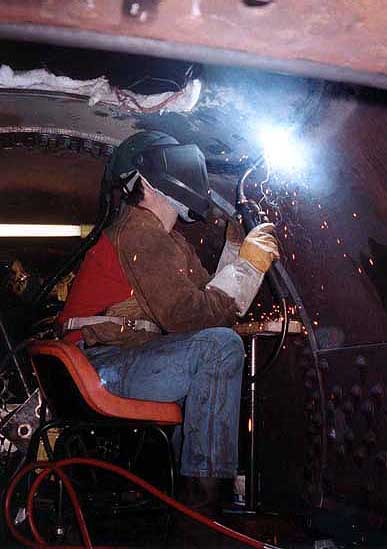

B10.jpg (35192 bytes) Jeff Miller welding on inside of boiler patch.  5/16/01. B11.jpg (57224 bytes) John Scondras welding on outside of boiler.  Jeff Miller welding on inside of boiler patch. Second Pass.  5/16/01.

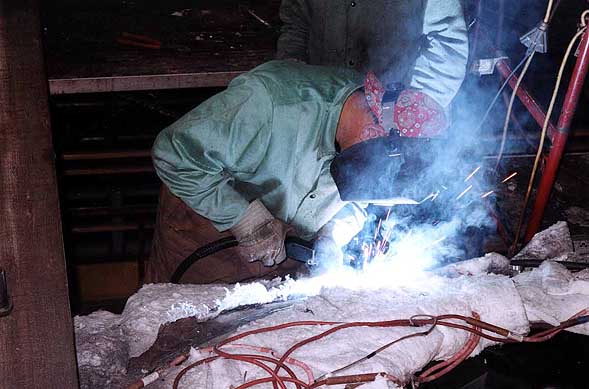

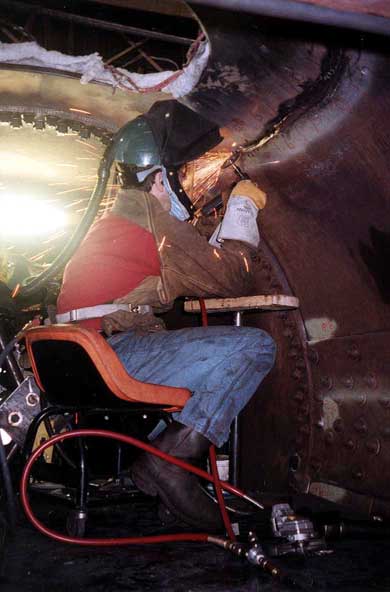

B12.jpg (47554 bytes) John Scondras welding on outside of boiler.  B13.jpg (36422 bytes) Jeff Miller grinding on inside of boiler patch.  5/16/01.

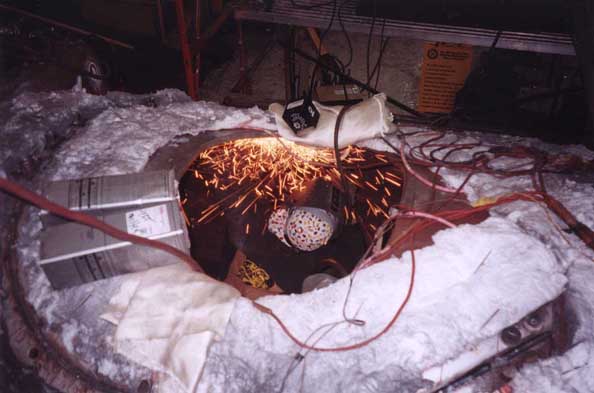

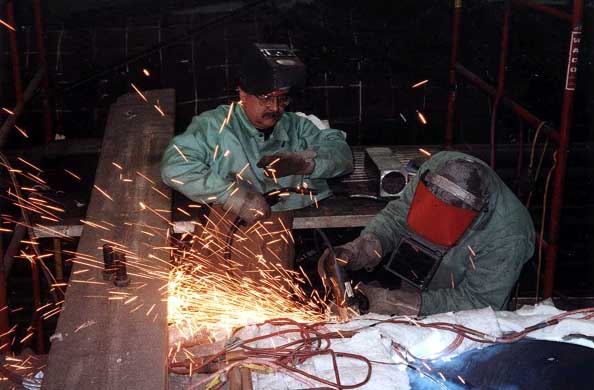

B14.jpg (45408 bytes) Bill Frederickson grinding on outside of boiler patch.  John Scondras  in background.  5/16/01.  B18.jpg (37990 bytes)  John Scondras grinding on inside of boiler patch. 5/15/01.

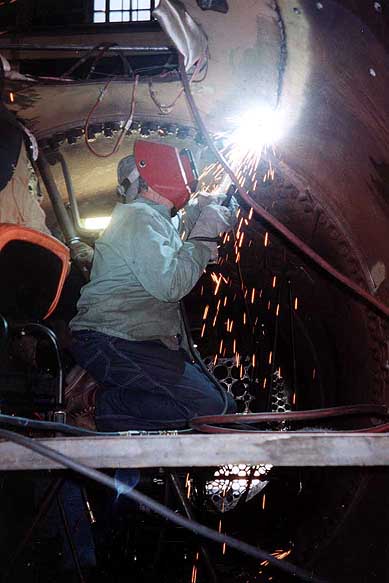

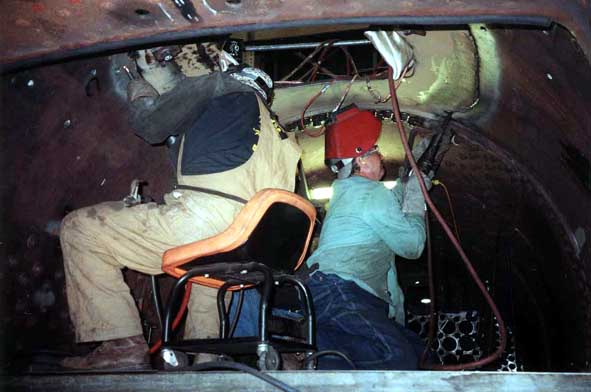

B15.jpg (38946 bytes) Bill Frederickson and  John Scondras  working on inside of boiler.  5/17/01. B16.jpg (39018 bytes) Bill Frederickson grinding on inside of boiler patch. 5/17/01.

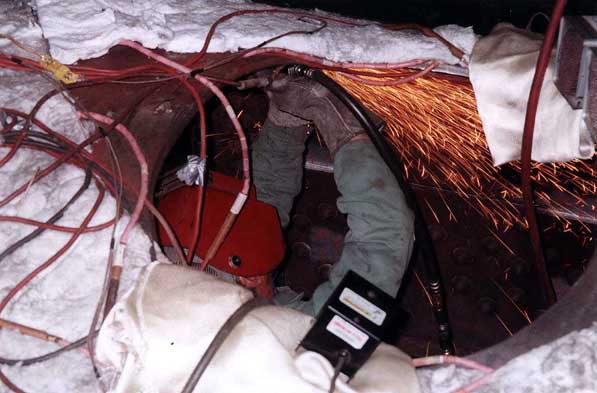

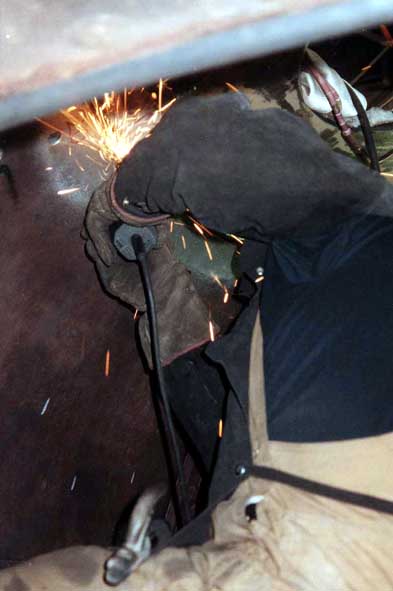

B17.jpg (46289 bytes) Bill Frederickson grinding on inside of boiler patch. 5/15/01. B19.jpg (28831 bytes) John Scondras grinding on inside of boiler patch. 5/17/01.



After the second pass was complete, the weld was “x-rayed” to ensure that the weld had no cracks or imperfections.   An imperfection two inches long was discovered.   As a result a two foot section was ground out and re-welded.   A second “x-ray” was conducted and found no cracks or imperfections.

The welding continued after the x-ray revealed no imperfections.   The final pass of weld was again subject to being x-rayed to ensure a good weld.   The final pass of weld passed the final x-ray leading to the next step of the project.   Using natural gas blowers, the section of boiler with the patch was heated to 1100 ° F to relieve the stress in the steel caused by the welding.   The boiler was slowly heated to 1100 ° F, held at 1100 ° F for one hour, then allowed to cool.

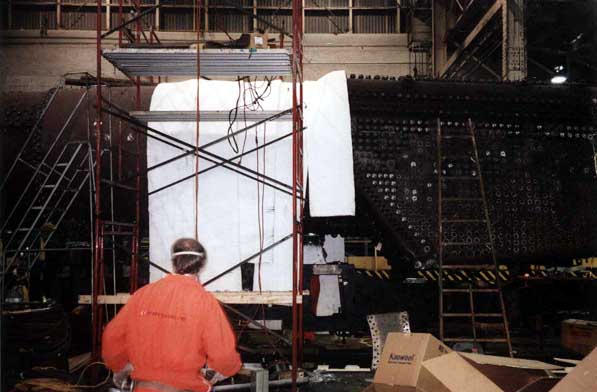

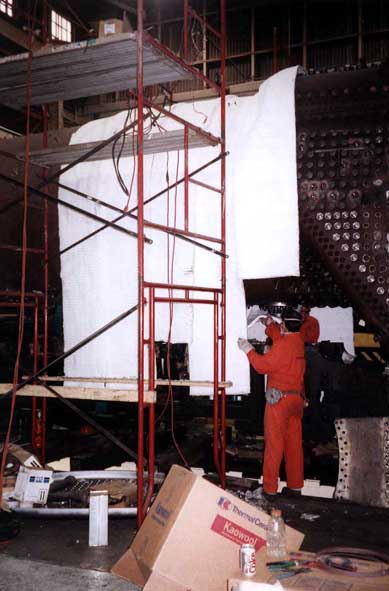

B20.jpg (43153 bytes) Cooper Heat employees insulating boiler for post weld heat treatment.  5/18/01 B21.jpg (42380 bytes) Cooper Heat employees insulating boiler for post weld heat treatment.  5/18/01

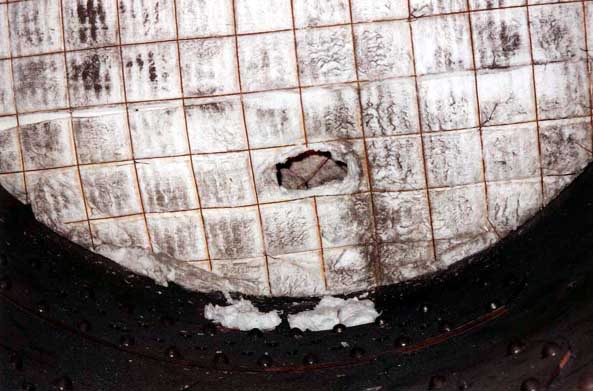

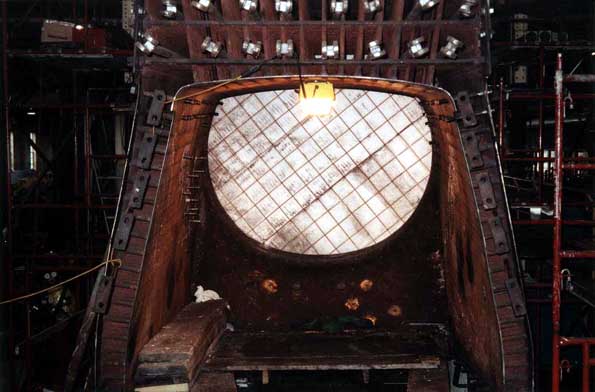

B22.jpg (42927 bytes) Insulation bulkhead inside boiler (throat of firebox.  5/18/01 B23.jpg (50782 bytes) Close up.  Insulation bulkhead for post weld heat treatment.  5/18/01.



The final step of the boiler patch project was to apply fault check to the weld to check for cracks.   No cracks were found.

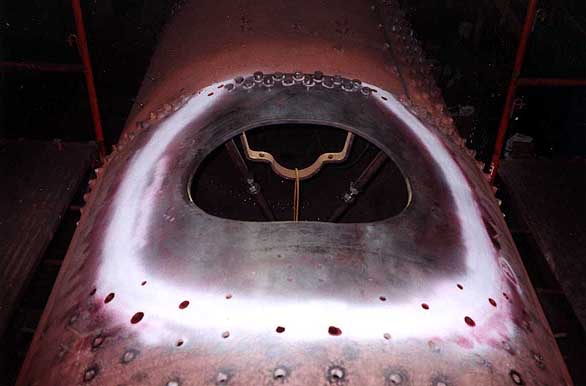

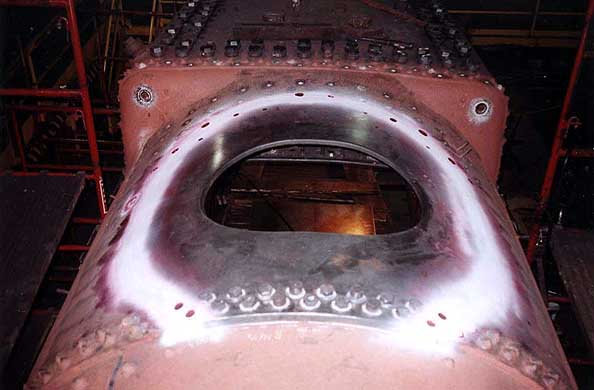

B24.jpg (35605 bytes) Boiler patch (from front of locomotive).  6/8/01 B25.jpg (29015 bytes) Boiler patch (from on top of firebox of locomotive).  6/8/01

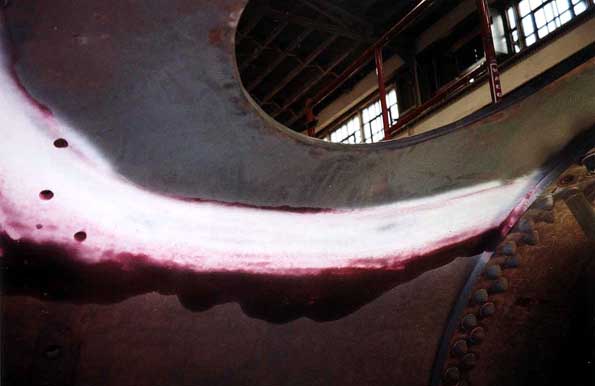

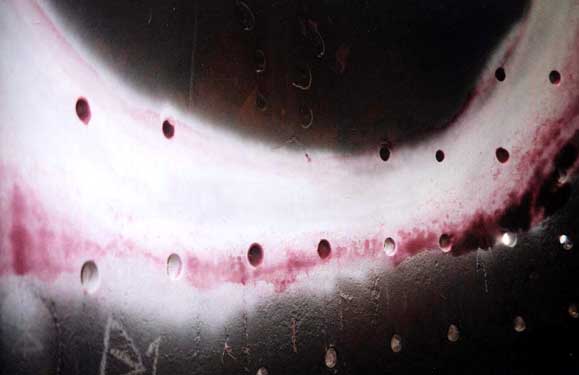

B26.jpg (26785 bytes) Left side of Boiler patch (inside) with fault check.  No cracks. 6/8/01 B27.jpg (22480 bytes) Back of boiler patch (inside) with fault check.  No cracks. 6/8/01

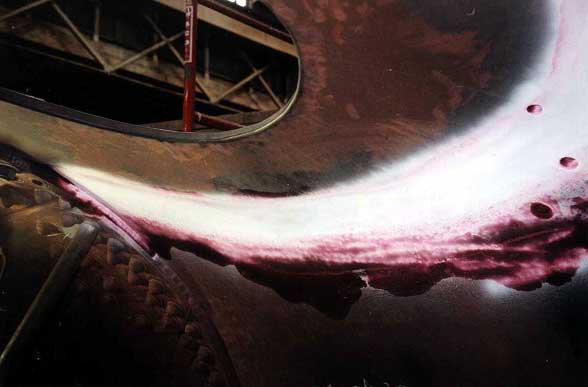

B28.jpg (27282 bytes) Right side of boiler patch (inside) with fault check.  No cracks. 6/8/01 B29.jpg (53816 bytes) Brian J. Behe examining boiler patch.  6/8/01
